Translate

Friday, July 13, 2012

Asphalt Pavement

WORK PROGRAM FOR ASPHALT

SITE PREPARATION
  1. Paver will be in ready position at a day prior.
  2. Cleaning will be done at a day prior.
  3. Survey will be clear in all respects i.e. centre line, installing pages etc at
  4. Sensor wire will be fixed and levels will be reconfirmed in morning before lying asphalt.
  5. All joints i.e. horizontal and longitudinal will be cut in ready position on the same day of lying of asphalt.

PLANT PREPARATION
  1. Asphalt plant will start at then and will close 5~
  2. Laying will start at 6:00 p.m.

ASPHALT PROGRESS
Total working time of plant    =          12 ~ 14 hrs.
Total production                     =          600 ~ 900 ton
PAVER POSITION
  • Two number Pavers will be used for full width laying.
  • Total width of ACBC is 12.05m.
  • 1st Paver will installed on outer side of carriageway covering 8.4 m.
  • 2nd Paver will be installed on inner side covering 3.65 m.
  • 2nd Paver will start working 45 m after laying of ACBC by the 1st Paver.
  • 3 sensor wires will be used. 1st Paver will be working on 2 sensor wires and 2nd Paver will be working on a sensor wire outside and inside it will be sensoring the ACBC layed by the 1st Paver.
  • Tandem and PTR will work on longitudinal joint after laying of ACBC by 2nd Paver.

Note:   Rolling will stop 3 hrs after the laying of last dumper.
ACBC CONSUMPTION (11 cm Layer)
1st Paver (8.4 m)                                              =          2.3 Ton / running meter
2nd Paver (3.65 m)                                           =          1 Ton / running meter
If working in full width total length per day  =          180 m ~ 270 m
If only 1st Paver working                                =          260 m ~ 390 m
If only 2nd Paver working                               =          600 m  ~ 900 m


PLANT REQUIREMENT
Asphalt Plant              1 No                            Must be in perfect condition 2 days before 1 in case
Loader                         2 No                            of B/D

MATERIAL
Bitumen / day             23 ~ 34 Ton
Diesel                          4800 ~ 7500 Ltr
RC 250                        1 Drum
Cooking Oil                20 Ltr
Khaka                          as per JMF
Aggregate                   as per JMF

MACHINERY REQUIREMENT
REQUIRED:
AVAILABLE:
BALANCE:

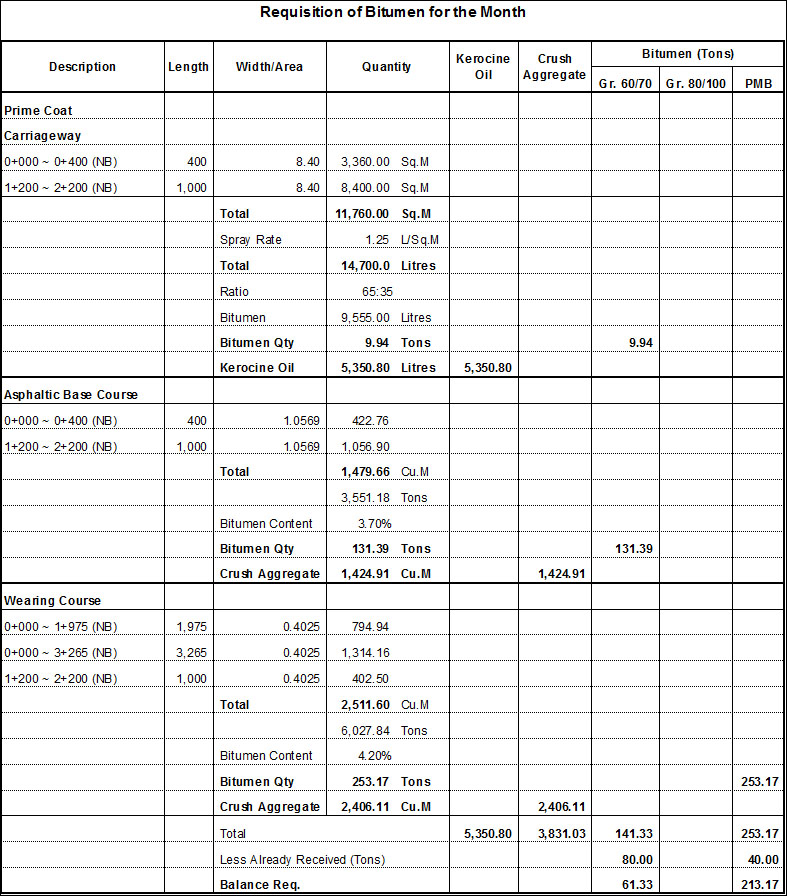

            Requisition of Bitumen
